Rumble builds a faster path to Western Queen gold production

Rumble Resources has moved Western Queen closer to a potential 2027 gold start, pairing a larger resource with third-party processing access and A$10 million in royalty funding. The project remains pre-production, however, with approvals, financing, feasibility work and a final investment decision still outstanding.

  • Western Queen gold resource rises 17% to 433,600oz
  • Indicated Resources increase 54% to 227,700oz
  • Five-year toll milling pathway established with Kirkalocka
  • A$11.1 million cash balance at 30 June 2026
  • Going concern remains dependent on future capital raising
An image related to Rumble Resources Limited
Image © middle. Logo © respective owner.

Western Queen moves from discovery towards development

Rumble Resources Ltd (ASX:RTR) is no longer presenting Western Queen as merely a promising exploration story. Its annual report describes a project being assembled for production, with the gold resource now at 5.13 million tonnes grading 2.6 grams per tonne for 433,600 ounces, a 17% increase in contained gold from the prior estimate. More importantly for mine planning, Indicated Resources rose 54% to 227,700 ounces.

The upgrade includes a new Western Queen Central high-grade zone of 145,000 tonnes at 11.3g/t gold for 52,500 ounces. Drilling at Western Queen South also extended mineralisation more than 500 metres down-plunge, including an intercept of 12.2 metres at 5.13g/t. The company says the deposits remain open along strike and at depth, but these are Mineral Resources rather than Ore Reserves and do not, by themselves, establish economic viability.

Third-party processing lowers the construction burden

Rumble’s clearest development step was its toll milling and blending agreement with Gylden Resources and Kirkalocka Gold SPV. The arrangement provides for forecast Western Queen gold ore to be processed at the Kirkalocka plant for five years, creating a pathway that avoids the need to build a dedicated processing facility at Western Queen.

That arrangement sits alongside the A$10 million received from Elemental Royalties for a 2.5% net smelter return royalty over Western Queen gold production. Rumble recorded the consideration as a reduction in its exploration and evaluation asset rather than revenue. At 30 June, cash stood at A$11.10 million, compared with A$1.89 million a year earlier, after a A$9 million capital raise and the royalty transaction.

Study economics remain preliminary

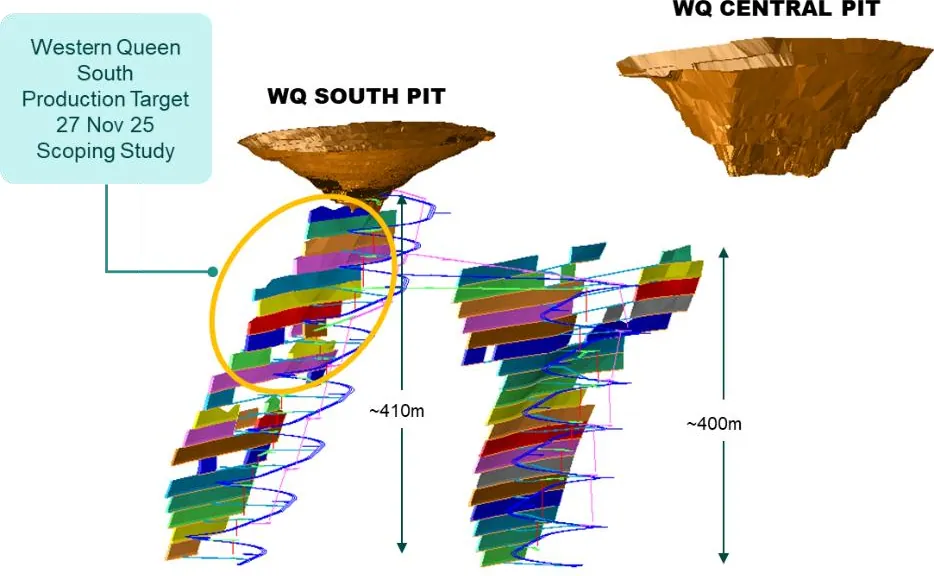

The November 2025 underground scoping study for Western Queen South outlined a two-year production target of 617,000 tonnes at 2.95g/t for 58,500 contained ounces. It estimated A$133 million of free cash flow, an A$112 million NPV at an 8% discount rate and a 370% IRR, based on a gold price of A$5,540 an ounce. The study also estimated all-in sustaining costs of A$2,970 an ounce and upfront pre-development capital below A$10 million.

Those figures are powerful, but they are still scoping-study figures. The updated study is intended to incorporate the larger resource, the new Central high-grade zone, revised mining schedules, updated costs and the toll-milling terms. Rumble has said a Bankable Feasibility Study and Decision to Mine are targeted for the December 2026 quarter, subject to positive study results and acceptable financing terms.

Funding and approvals remain the hard tests

The company has received works approval, native vegetation clearance and, after year-end, a groundwater extraction licence needed to dewater the Western Queen South pit. The Mine Development and Closure Proposal remains the major approval still outstanding. Rumble is also engaging underground mining contractors, preparing for pit dewatering and planning to invite debt providers to submit financing terms after the updated study.

The balance sheet is stronger, but it is not yet a production balance sheet. Rumble reported a FY2026 loss of A$2.96 million, improved from A$12.06 million, and operating cash outflows of A$2.44 million. Its accounts explicitly identify a material uncertainty around going concern because further capital is expected to be required, even though directors say forecasts support continued operations for the next 12 months.

Tungsten and exploration add optionality

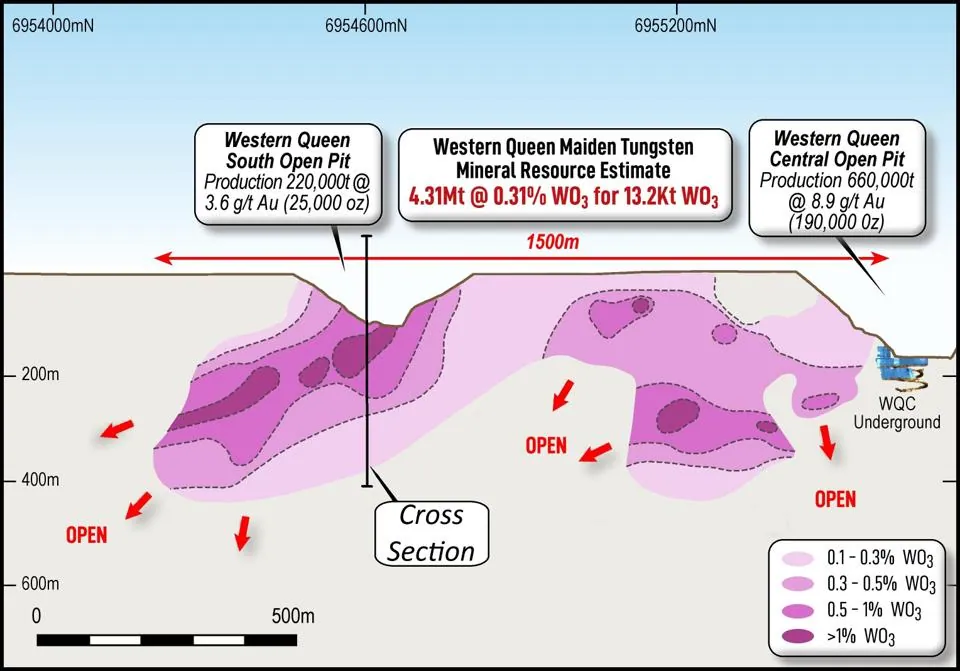

Western Queen also carries an Inferred tungsten resource of 4.31 million tonnes at 0.31% tungsten trioxide for 13,200 tonnes, including a higher-grade portion of 1.44 million tonnes at 0.51% for 7,400 tonnes. Preliminary testwork produced a 48% tungsten concentrate at 45% recovery through a flotation and gravity circuit, although payability, logistics and project economics still need to be established in a planned FY2027 scoping study.

Outside Western Queen, Munarra Gully produced a standout 13-metre gold intersection at 21.64g/t, including 5 metres at 55.56g/t, with copper mineralisation in the same fresh-rock zone. Rumble plans further drilling there, while a 5,000-metre aircore program is planned at Thunderstorm. These prospects offer exploration upside, but they also compete for capital and management attention as Western Queen enters the more demanding development phase.

Bottom Line?

Western Queen now has a larger resource and a credible processing route, but the investment case turns on whether the updated study can convert geological promise into financeable mine plans without another substantial equity raise.

Questions in the middle?

  • Will the updated Western Queen study expand the mine plan without materially increasing capital or operating costs?
  • Can Rumble secure project financing on terms that limit dilution before the targeted December 2026 Decision to Mine?
  • When will the tungsten resource generate a defined, payable revenue contribution rather than remain an optionality claim?
