Kinetiko advances Brakfontein gas project despite tight funding
Kinetiko Energy has moved its Brakfontein project closer to production, adopting a Phase 1 development plan and advancing permitting and CNG engineering. The progress comes with only 1.54 quarters of funding available, leaving the company reliant on pending capital and project payments.
- Phase 1 Brakfontein Field Development Plan adopted
- Bulk Sampling Permit application targeted for late October
- A$3.9 million placement tranche remains subject to approval
- Cash and equivalent funds stood at A$1.127 million
- First commercial gas remains targeted for late 2027
Add us as a preferred source on Google

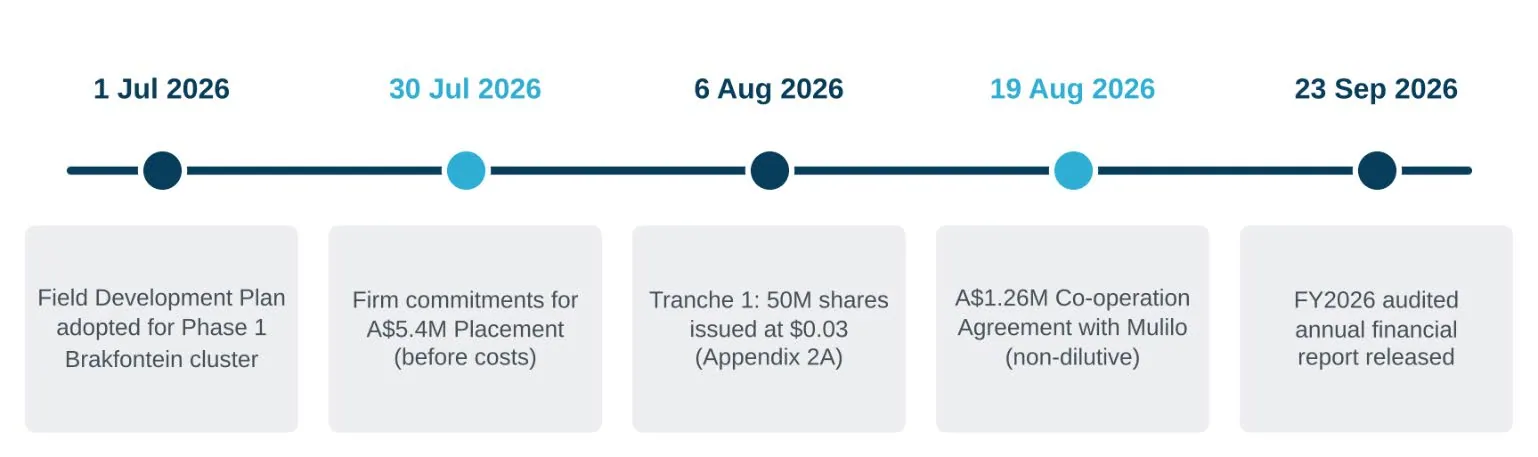

Brakfontein moves from planning into engineering
Kinetiko Energy Limited (ASX:KKO) is edging closer to its first gas production, but the quarter also exposed the funding constraint surrounding that ambition. The company adopted the Phase 1 Field Development Plan for its Brakfontein Rolling Cluster, completed concept design for a modular compressed natural gas facility and began detailed engineering, while reporting just 1.54 quarters of available funding at 30 September.
The plan centres on four existing wells connected to a central manifold and mobile CNG facility. Kinetiko says the shallow conventional gas accumulation has high methane content and minimal impurities, allowing a simpler processing configuration and avoiding fracking. Extended testing at Brakfontein had previously shown flows above the commercial threshold used in its reserve assessment, as reported in the Brakfontein gas tests coverage.
Permits and second cluster remain key milestones
With the development plan adopted, Kinetiko is preparing a Bulk Sampling Permit application and a Production Right application covering Exploration Right 271. The Bulk Sampling application is expected to be submitted to the Petroleum Agency of South Africa by the end of October, with approval anticipated in the first quarter of 2027, subject to the regulator’s process. The company is also progressing the environmental assessment supporting the broader Production Right application.
The engineering schedule is moving in parallel. Kinetiko has shortlisted a preferred supplier for the modular CNG facility, with contract award and front-end engineering targeted for the December quarter. Three potential sites have also been shortlisted for a further well intended to help determine the location of Cluster 2, with drilling planned to begin in early 2027. Those steps extend the Bulk Sampling Permit plan previously outlined by the company, but do not remove the approval and execution risks attached to the timetable.
Funding has improved, but remains conditional
Kinetiko received A$1.5 million before costs from the first tranche of a planned A$5.4 million placement during the quarter. The remaining 130 million shares, worth A$3.9 million, are yet to be issued and remain subject to shareholder approval. The placement was priced at 3 cents a share, with A$3 million of the proposed investment committed by Talent 10 Holdings, an entity associated with non-executive director Mxolisi Mgojo.
The company also recorded a non-dilutive cooperation agreement with Mulilo involving a Rand-equivalent cash consideration of A$1.26 million. The agreement resolves overlapping land use connected with the Newcastle wind project across an 18.54-square-kilometre exclusion zone, or about 1.1% of Exploration Right 270, and gives Afro Energy a right of first refusal to supply gas if gas-fired generation is procured. The arrangement had been reported as a Mulilo funding agreement, although the quarterly Appendix 5B separately refers to a $1.9 million settlement targeted for completion by 31 December. The filing does not explain the difference.
Cash runway puts timing under scrutiny
Kinetiko ended September with A$816,000 in bank cash and a further A$311,000 attributed to joint venture balances and funds advanced by FFS Refiners. Operating cash use was A$730,000 for the quarter, including A$213,000 on exploration and evaluation, A$383,000 on staff costs and A$398,000 on administration and corporate costs. On the company’s calculation, those figures provide 1.54 quarters of funding at the current rate of outflow.
Kinetiko said it expects to continue operating on the basis of the pending second placement tranche and the Mulilo settlement. That leaves several near-term dependencies stacked against the late-2027 first-commercial-gas target: shareholder approval, receipt of conditional project funding, permitting, the CNG contract and the appointment of a new chief executive. The next quarter should show whether the transition to producer is being funded as decisively as it is being designed.
Bottom Line?
Brakfontein has entered a more tangible development phase, but the production timetable still depends on funding that is partly unissued or conditional.
Questions in the middle?
- Will shareholders approve and Kinetiko issue the remaining A$3.9 million placement tranche?
- Will the Mulilo project reach financial close and deliver the expected cash, and what explains the filing’s A$1.26 million versus $1.9 million references?
- Can permitting, CNG procurement and Cluster 2 drilling progress without materially increasing the company’s funding requirement before first gas?
